Package 1, Provincial Road 822B focuses on project implementation and investment capital disbursement
Disbursement reaches 70.25% of the plan assigned by the Prime Minister
Determining that investment implementation and capital disbursement play an important role in promoting socio-economic growth, from the beginning of the year, the Provincial People's Committee focused on leadership and direction in implementation. The province established working groups to inspect and urge disbursement, required investors to report results and difficulties weekly, and promptly resolved problems, so that the province's public investment capital disbursement rate was quite good compared to the plan and compared to the whole country.
According to Document No. 616 dated November 7, 2025 of the Ministry of Finance, by October 31, 2025, Tay Ninh province disbursed 70.25% of the plan assigned by the Prime Minister, ranking 8th out of 34 provinces and cities and 14/77 investors nationwide (the average disbursement rate of the whole country is 50.7%). Although facing many difficulties in construction implementation due to weather, scarcity of raw materials, etc., the investor closely coordinated with the contractor of Provincial Road 822B and related units to ensure the project's progress as well as disbursement of capital according to plan.
According to the representative of the construction unit of package 1 of Provincial Road 822B, Tran Thanh Hung, the unit is currently constructing the roadbed, filling sand, and leveling, and progress has reached more than 40% of the plan. The disbursement is also being implemented quickly and currently reaches about 30%, expected to be completed in April 2026. The unit focuses on arranging adequate human resources, equipment, and machinery, proactively implementing construction plans, and working throughout to ensure project progress as well as completing procedures for payment and settlement of volume according to plan.
.jpg)

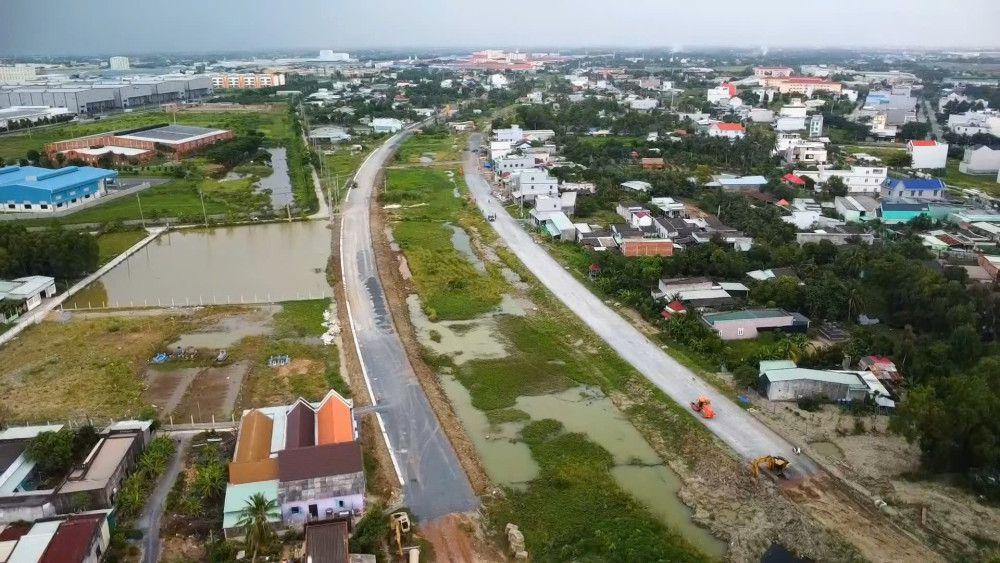

As of November 5, 2025, the province has disbursed 65.32% of the capital plan (Photo: Bidding package from Nguyen Van Nham Street to National Highway 1 under the Provincial Road 830E project; the volume of implementation and disbursement is about 60%)

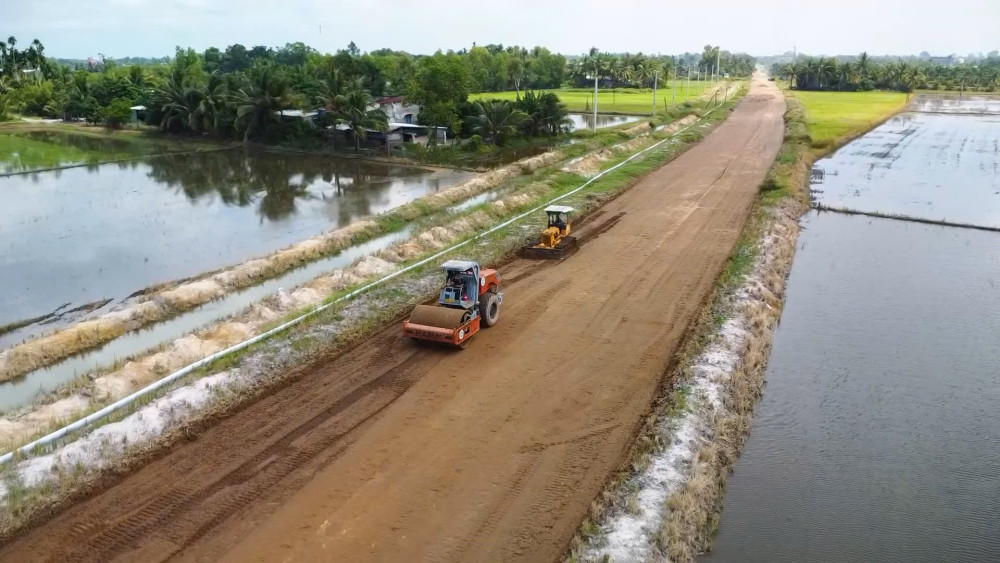

The Provincial Road 822B project has a length of 11.35km with a total investment of nearly 1,000 billion VND. In phase 1, the province invests in a grade IV road, 9m base, 7m wide road surface, and site clearance according to the planning of 30m; Central budget support capital is 300 billion VND, and the rest is provincial budget capital and other legally mobilized capital sources. In 2025, 170 billion VND was allocated, so far more than 100 billion VND has been disbursed, reaching 61.03% of the plan.
Similarly, at the Provincial Road 830E project (section from the Ho Chi Minh City - Trung Luong expressway intersection to Provincial Road 830), the investor, contractor, and related units focused on overcoming difficulties in the project implementation process and speeding up the implementation progress as well as disbursement according to plan. The project has a total investment of more than 3,700 billion VND, of which the construction investment is over 1,200 billion VND and the site clearance costs nearly 2,500 billion VND.
Representative of the construction unit of the package from Nguyen Van Nham Street to National Highway 1 (unit on the left side of the route) Ly Xuan Vy said, “Currently, we are carrying out construction on the roadbed, pouring curbs, the progress as well as the disbursement rate is about 60%. The project still has some land problems; the unit is proactively coordinating with the investor and local authorities to propagate and mobilize people to hand over the land to do the project soon, concentrate human resources and equipment to rush construction, and complete the items according to the signed contract.”
Promoting the highest spirit
.JPG)
Tay Ninh province is one of the localities where investors have a fairly good disbursement rate compared to the whole country (Illustration: Workers constructing a project in Long An ward)
In addition to the achieved results, the disbursement of investment capital in the area still faces certain difficulties and limitations, causing the disbursement rate to not reach the plan set by the province. Of the 33 investors using the provincial budget, 7 investors disbursed over 75% of the plan, 14 investors disbursed from 50 to 75% of the plan, 12 investors disbursed less than 50% of the plan (of which 5 investors have not disbursed).
According to the Department of Finance, the main reason affecting the province's disbursement is that the site clearance of some projects is still slow; Most of the projects implemented until 2025 are mainly completed to settle the project, so this volume is not much, and the final payment will be made after the settlement, unfavorable weather interrupting construction, and at some points, these projects lacking raw materials.
In order to focus on removing obstacles, speeding up the implementation progress as well as disbursing capital, striving to achieve 100% of the capital plan for 2025, Deputy Director of the Department of Finance Nguyen Tan Qui requested the provincial departments, branches, People's Committees of communes and wards, project management boards, and investors to seriously implement the direction of the Provincial People's Committee on urging the completion of allocation procedures and promoting the disbursement of public investment capital in 2025; investors urgently urge contractors to construct and disburse to increase the disbursement rate so that by the end of the fourth quarter, disbursement will be over 95% of the plan and by the end of the fiscal year, disbursement will reach 100% of the plan according to the direction of the Chairman of the Provincial People's Committee. Investors need to speed up the implementation progress, develop implementation plans, speed up the bidding process, and assign staff to monitor each specific project.
In particular, units need to continue to promote and uphold the highest spirit in deploying and implementing public investment projects. Investors must urgently review and carry out the handover and acceptance of projects to report the list and capital plan of each new investor.
On the other hand, investors need to urgently complete procedures, start projects soon, especially key projects, speed up the implementation progress and disbursement of projects. The Department of Construction and the Department of Agriculture and Environment must guide and support investors to complete investment procedures so that the competent authority can soon approve the project as a basis for capital allocation; 2 working groups of the Provincial People's Committee continue to closely monitor the progress of implementation and disbursement of the 2025 capital plan to promptly urge and resolve problems for investors, especially investors with low disbursement rates, promptly report to the Provincial People's Committee for resolution if exceeding authority./.
| The total capital allocated by the Provincial People's Committee in 2025 is nearly 17,000 billion VND. By November 5, 2025, the implementation volume is more than 11,000 billion VND, reaching 65.33% of the plan; the disbursement volume is 11,000 billion VND, reaching 65.32% of the capital plan allocated by the Provincial People's Committee. |
